Key Takeaways
- AHJ lookups identify the governing authorities, adopted codes, permit fees, and submission requirements for any project address
- Manual lookups average 30–90 minutes per project; automated tools reduce this to under 5 minutes
- Critical data includes adopted NEC edition, fire setback rules, required documents, PE stamp requirements, and fees
- Over 20,000 AHJs exist in the US alone, each with potentially different requirements
- Incorrect AHJ identification leads to wrong code compliance, rejected permits, and wasted design time
- Integrating AHJ data into solar design software streamlines the entire permit-to-install workflow
What Are AHJ Lookups?

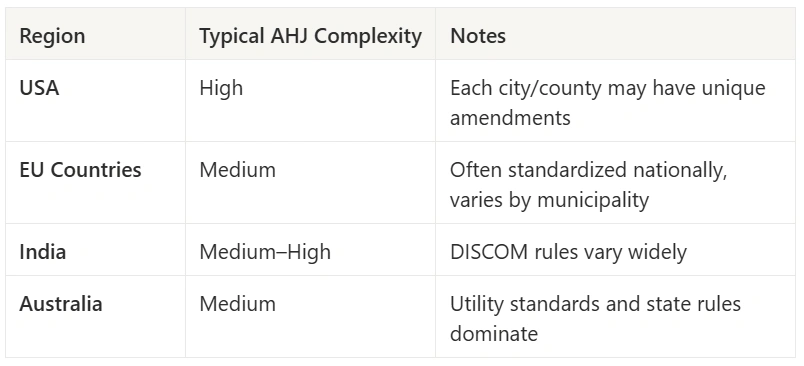

AHJ lookups are the research process of identifying which Authority Having Jurisdiction (AHJ) governs a solar installation site and what specific requirements that authority enforces. This includes the adopted building and electrical codes, fire setback rules, permit application procedures, required documentation, fees, review timelines, and inspection protocols.
With over 20,000 jurisdictions in the United States — each potentially enforcing different code editions, local amendments, and procedural requirements — AHJ lookups are one of the most time-consuming administrative tasks in the solar permitting workflow.
A 2024 NREL study found that soft costs (permitting, inspection, interconnection) account for 30–40% of residential solar system costs. Reducing AHJ lookup time is one of the fastest ways to cut these soft costs.
How AHJ Lookups Work
The lookup process varies based on whether you’re using manual research or automated tools:
Determine Jurisdiction Boundaries
Identify whether the project address falls within a city, town, township, or unincorporated county area. Boundary lines determine which building department has authority. Some addresses near municipal borders require verification with the county assessor.
Identify All Applicable AHJs
A single project may involve multiple AHJs: building department, electrical inspector, fire marshal, planning/zoning board, HOA, and utility. List every entity that requires notification or approval.
Research Adopted Code Editions
Determine which edition of the NEC, IBC, IFC, and any state energy code the AHJ enforces. This is critical — designing to NEC 2023 when the AHJ enforces NEC 2017 can cause permit rejection.
Identify Local Amendments
Check for local amendments that modify or exceed the adopted national codes. Common amendments include additional fire setbacks, stricter structural requirements, and specific equipment restrictions.
Document Submission Requirements
Record the required permit documents, application forms, submission format (online portal vs. in-person), PE stamp requirements, fee schedule, and expected review timeline.
Verify Utility Interconnection Rules
Contact the serving utility to determine interconnection application requirements, system size limits, metering type, and net metering or net billing policy. This runs parallel to the building permit process.
Manual vs. Automated AHJ Lookups
The solar industry is shifting from manual research to database-driven automated lookups. Here’s how they compare:
Manual Lookups
Involves calling or visiting the AHJ website, searching for adopted ordinances, reviewing code amendment documents, and compiling requirements. Accurate but time-intensive: 30–90 minutes per project for experienced staff.
Automated Database Lookups
Software tools that map project addresses to AHJ boundaries and return pre-compiled requirement profiles. Lookups take under 5 minutes. Databases are maintained by third-party providers or built internally by larger solar companies.
Design Software Integration
Solar design software with built-in AHJ databases automatically applies jurisdiction-specific rules to the design — fire setbacks, code requirements, and permit templates — based on the project address.
AI-Powered Lookups
AI tools that scrape AHJ websites, parse code documents, and maintain real-time requirement databases. AI assistants can interpret complex local amendments and flag conflicts between overlapping jurisdictions.
Even with automated tools, always verify critical requirements (adopted NEC edition, PE stamp requirement, fire setback dimensions) directly with the AHJ for high-value or unusual projects. Databases can lag behind recent code adoptions by weeks or months.
Key Data Points in an AHJ Lookup
A complete AHJ lookup should capture all of these data points:
| Data Point | Why It Matters | Example |
|---|---|---|
| Adopted NEC Edition | Determines which electrical code rules apply | NEC 2020 vs. NEC 2023 |
| Fire Setback Requirements | Defines usable roof area for panels | 3 ft ridge, 18 in eave (CA Fire Code) |
| PE Stamp Required | Determines if a licensed engineer must sign plans | Required for systems over 15 kW |
| Permit Fee | Affects project cost and proposal accuracy | $250 flat fee or $15/kW |
| Review Timeline | Sets customer expectations for project schedule | 5 business days to 6 weeks |
| Submission Method | Determines how to file the application | Online portal, email, or in-person |
| Utility Serving Area | Identifies the interconnection authority | Pacific Gas & Electric (PG&E) |
| Net Metering Policy | Affects system sizing and financial modeling | NEM 3.0 (net billing at avoided cost) |
Annual Savings = Projects/Year × (Manual Lookup Time − Automated Time) × Hourly Labor CostFor a company completing 500 residential projects per year: 500 × (1 hr − 0.08 hr) × $45/hr = $20,700/year in labor savings from automated AHJ lookups alone.
Practical Guidance
AHJ lookups are relevant to every role in a solar company:
- Run the AHJ lookup before starting the design. Knowing the fire setbacks, equipment restrictions, and code edition before you place the first panel prevents redesign work. Feed AHJ data directly into your solar design software workflow.
- Check for SolarAPP+ participation. If the AHJ uses SolarAPP+, the design must meet specific eligibility criteria. Systems that qualify get instant permit approval, saving weeks of review time.
- Verify PE stamp requirements. Some AHJs require a Professional Engineer stamp on structural calculations, electrical plans, or both. Knowing this upfront avoids last-minute engineering review costs.
- Note AHJ-specific document requirements. Some AHJs want load calculations on the plan set; others want them as a separate attachment. Match the format to what the reviewer expects to speed approval.
- Know the inspection scheduling process. Some AHJs allow online scheduling; others require phone calls during limited hours. Plan your installation completion dates around the AHJ’s inspection availability.
- Build relationships with local inspectors. Inspectors in your primary service area will review most of your work. Understanding their preferences and common correction items helps you achieve higher first-pass rates.
- Track AHJ turnaround trends. AHJ review times fluctuate seasonally (slower in spring/summer when solar applications peak). Adjust your project scheduling to account for these patterns.
- Keep current contractor licenses. Many AHJs verify that the installing contractor holds valid electrical and/or general contractor licenses for that jurisdiction. Expired or out-of-jurisdiction licenses cause immediate permit denial.
- Include permit costs in every proposal. AHJ permit fees range from $0 to $2,000+. Running a quick AHJ lookup during the sales visit lets you quote accurate permit costs in the solar proposal rather than estimating.
- Set accurate project timelines. Tell customers the realistic permit review timeline for their jurisdiction. A customer told “2 weeks to install” who waits 6 weeks for a permit will lose confidence in your company.
- Know system size limits. Some AHJs or utilities cap residential system sizes (e.g., 10 kW, 25 kW, or 100% of historical consumption). Verify limits before proposing a system that can’t be permitted.
- Use AHJ data as a competitive advantage. Sales teams that can answer “How long will the permit take?” and “What are the fees?” during the first visit demonstrate expertise that builds customer confidence.
Automate AHJ Research for Every Project
SurgePV integrates AHJ data directly into the design workflow — fire setbacks, code requirements, and permit templates applied automatically by address.
Start Free TrialNo credit card required
Real-World Examples
High-Volume Installer: Database-Driven Lookups
A national solar installer operating in 15 states maintains an internal AHJ database covering 2,400 jurisdictions. When a sales rep enters a project address, the system automatically returns the AHJ contact info, adopted codes, fire setback rules, PE stamp requirements, permit fees, and average review timeline. This database reduced average permit preparation time from 2.5 hours to 25 minutes per project and cut permit rejection rates from 22% to 6%.
Regional Company: Manual Lookup Challenge
A regional installer expanding from Texas into Oklahoma encounters unfamiliar AHJs. The first three permit applications are rejected — one for designing to the wrong NEC edition (2023 instead of the AHJ’s adopted 2017), one for missing a local fire setback amendment, and one for not including a required structural attachment detail specific to that county. Each rejection costs 2–3 weeks of delay and an average of $400 in redesign labor. After building an AHJ database for their new service area, rejections drop to near zero.
SolarAPP+ Adoption: Instant Permit
A solar company in Tucson, AZ discovers through an AHJ lookup that the city participates in NREL’s SolarAPP+ program. They design a 6.5 kW residential system that meets all SolarAPP+ eligibility criteria (standard residential, listed equipment, code-compliant design). The permit is approved automatically in 20 minutes through the online portal. The customer goes from contract signing to installation in 5 days — compared to the 3-week average for non-SolarAPP+ jurisdictions.
Impact on Solar Business Operations
AHJ lookup efficiency directly affects a company’s operational metrics:
| Metric | Without AHJ Database | With AHJ Database |
|---|---|---|
| Lookup Time | 30–90 min/project | under 5 min/project |
| Permit Rejection Rate | 15–25% | under 8% |
| Average Permit Timeline | Extended by corrections | First-pass approval |
| Design Revision Rate | 20–30% of projects | under 10% |
| Customer Satisfaction | Delays frustrate customers | Accurate timelines build trust |
| Scalability | Bottleneck in new markets | Rapid expansion capability |
When entering a new service area, invest time upfront to build your AHJ database for the top 10 jurisdictions by volume. Call each building department, request their solar permit checklist, and record the adopted code editions and local amendments. This one-time investment pays for itself within the first 5–10 projects.
Sources & References
Frequently Asked Questions
What is an AHJ lookup in solar?
An AHJ lookup is the process of researching which government authority controls solar permitting for a specific project address and what their requirements are. This includes identifying the adopted electrical code version, fire setback rules, required permit documents, fees, and review timelines. Solar companies perform AHJ lookups for every project to ensure their designs and permit packages meet local requirements.
How many AHJs are there in the United States?
There are over 20,000 jurisdictions in the US that can function as AHJs for solar installations. This includes cities, counties, townships, and special districts, each with their own adopted codes, local amendments, and permitting procedures. This fragmentation is one of the main reasons solar soft costs remain high compared to countries with more centralized permitting.
Can AHJ lookups be automated?
Yes. Several solar software platforms and third-party services maintain AHJ databases that map project addresses to jurisdiction boundaries and return pre-compiled requirement profiles. These tools reduce lookup time from 30–90 minutes to under 5 minutes. Some solar design software platforms integrate AHJ data directly into the design workflow, automatically applying the correct fire setbacks and code requirements based on the project address.
What information should an AHJ lookup include?
A complete AHJ lookup should capture: the adopted NEC edition, local code amendments, fire setback requirements, PE stamp requirements, required permit documents, submission method (online/in-person), permit fees, expected review timeline, inspection scheduling process, and utility interconnection requirements. For full compliance, also note any equipment restrictions or special conditions unique to that jurisdiction.
About the Contributors
CEO & Co-Founder · SurgePV
Keyur Rakholiya is CEO & Co-Founder of SurgePV and Founder of Heaven Green Energy Limited, where he has delivered over 1 GW of solar projects across commercial, utility, and rooftop sectors in India. With 10+ years in the solar industry, he has managed 800+ project deliveries, evaluated 20+ solar design platforms firsthand, and led engineering teams of 50+ people.
Content Head · SurgePV
Rainer Neumann is Content Head at SurgePV and a solar PV engineer with 10+ years of experience designing commercial and utility-scale systems across Europe and MENA. He has delivered 500+ installations, tested 15+ solar design software platforms firsthand, and specialises in shading analysis, string sizing, and international electrical code compliance.
