Key Takeaways
- Albedo is the reflectivity of a surface — higher albedo means more sunlight is reflected back toward the panels
- Values range from 0.04 (dark asphalt) to 0.90 (fresh snow)
- Ground-reflected light can increase energy yield by 1–5% for monofacial panels and 5–30% for bifacial panels
- Default albedo values in simulation software (typically 0.20) may under- or overestimate production if not adjusted for actual site conditions
- Albedo varies by season, weather, and surrounding surface materials
- Accurate albedo input is critical for reliable production estimates in solar design software
What Is Albedo?
Albedo (from the Latin word for “whiteness”) is a dimensionless measure of how much incoming solar radiation a surface reflects. It’s expressed as a value between 0 and 1, where 0 means the surface absorbs all incoming light and 1 means it reflects all of it.
In solar energy, albedo matters because the ground and surrounding surfaces reflect sunlight back upward toward the solar panels. This reflected light — called ground-reflected irradiance — contributes to the total energy reaching the panel surface, particularly for tilted arrays and bifacial modules.
For monofacial panels, albedo accounts for 1–5% of total energy yield. For bifacial panels, it can contribute 10–30% of rear-side production — making accurate albedo measurement one of the most impactful inputs in bifacial system design.
How Albedo Affects Solar Production
Albedo influences solar production through a specific physical process:
Sunlight Hits the Ground
A portion of solar irradiance — both direct and diffuse — reaches the ground and surrounding surfaces around the solar array.
Surface Reflects a Fraction
The surface reflects a fraction of the incoming light equal to its albedo value. Dark surfaces absorb most light (low albedo); light surfaces reflect more (high albedo).
Reflected Light Reaches Panels
The reflected light travels upward and strikes the front surface of tilted panels (contributing to total POA irradiance) or the rear surface of bifacial panels.
Panels Convert to Electricity
The panel absorbs the reflected photons and converts them to electricity, just like directly incident sunlight. This additional energy increases the system’s total yield.
G_reflected = GHI × Albedo × View FactorThe view factor depends on the panel tilt angle — steeper tilts “see” more ground and capture more reflected light.
Albedo Values for Common Surfaces
Surface material dramatically affects albedo. Here are typical values used in solar design:

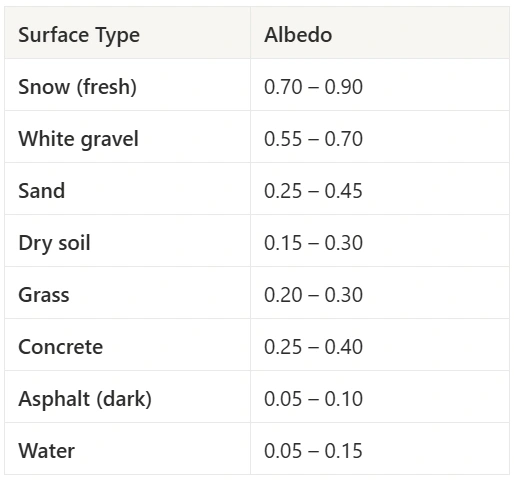

| Surface | Albedo | Notes |
|---|---|---|
| Fresh snow | 0.80–0.90 | Highest natural albedo; melts quickly |
| Aged snow | 0.40–0.70 | Decreases as snow ages and compacts |
| White membrane roof | 0.60–0.80 | Common on commercial flat roofs |
| Concrete (new) | 0.30–0.50 | Varies by color and finish |
| Light-colored gravel | 0.25–0.35 | Common ground-mount surface |
| Green grass | 0.20–0.25 | Default value in many simulators |
| Aged concrete | 0.15–0.25 | Darkens with weathering |
| Bare soil | 0.10–0.20 | Varies by moisture and color |
| Dark asphalt | 0.04–0.12 | Lowest common albedo |
| Water | 0.06–0.10 | Low at high sun angles |
Most solar simulation software defaults to an albedo of 0.20 (green grass). If your project site has white roofing membrane, concrete, or seasonal snow cover, you’re likely underestimating production. Conversely, a dark asphalt parking lot has albedo well below the default — overestimating production if not corrected.
Impact on Bifacial vs. Monofacial Panels
The albedo effect differs dramatically between panel technologies:
Monofacial Panels
Only the front side absorbs light. Ground-reflected irradiance contributes 1–5% of total production. The contribution is highest for steeply tilted panels (30°+) that “see” more ground surface.
Bifacial Panels
Both front and rear sides generate electricity. The rear side captures ground-reflected light directly. Bifacial gain ranges from 5% (low albedo) to 30% (high albedo), making albedo one of the most important design inputs for bifacial systems.
| Scenario | Monofacial Gain from Albedo | Bifacial Gain from Albedo |
|---|---|---|
| Dark asphalt (0.08) | ~1% | ~5–8% |
| Green grass (0.20) | ~2–3% | ~10–15% |
| White roof (0.70) | ~4–5% | ~20–30% |
| Fresh snow (0.85) | ~5% | ~25–35% |
Practical Guidance
Albedo affects design decisions, production estimates, and financial projections:
- Measure or estimate site-specific albedo. Don’t rely on the default 0.20. Check the actual ground surface material and adjust the albedo input in your solar design software for accurate production estimates.
- Use seasonal albedo for snow regions. If the site gets winter snow, model higher albedo (0.60–0.80) during winter months and ground-surface albedo during summer. Some tools allow monthly albedo inputs.
- Optimize bifacial systems for high-albedo surfaces. On white membrane roofs or light-colored ground surfaces, bifacial modules generate significantly more energy. Factor this into the cost-benefit analysis when choosing between mono and bifacial panels.
- Consider albedo enhancement. For ground-mount bifacial installations, white gravel or reflective ground cover beneath the array can increase rear-side irradiance by 50–100%. Model the production gain against the ground preparation cost.
- Maintain ground cover conditions. For ground-mount systems designed with specific albedo assumptions, keep vegetation height consistent. Overgrown vegetation reduces effective albedo and shades the rear of bifacial panels.
- Install reflective materials when specified. If the design calls for albedo enhancement (white gravel, reflective sheeting), ensure proper installation coverage and drainage. Incomplete coverage reduces the expected production gain.
- Document ground conditions. Take photos of the ground surface beneath and around the array at installation. This documentation supports production guarantee claims if ground conditions change later.
- Ensure adequate clearance for bifacial. Bifacial panels need sufficient ground clearance (typically 0.5–1.5 m minimum) for reflected light to reach the rear side. Mounting too low negates the albedo benefit.
- Upsell bifacial on high-albedo sites. White commercial roofs and light-colored ground surfaces make a strong case for bifacial panels. Use the generation and financial tool to show the production gain and faster payback.
- Explain albedo in simple terms. Tell customers: “The lighter the surface around your panels, the more sunlight bounces back up and gets captured — like how you feel warmer on a beach than in a forest.”
- Use conservative albedo in proposals. When presenting financial projections, use the lower end of the albedo range. Under-promising and over-delivering builds long-term customer trust and referral potential.
- Note seasonal production variations. In snow regions, explain that winter production may be higher than expected due to snow reflection — this is a positive surprise that reinforces the customer’s decision.
Model Albedo Effects with Precision
SurgePV’s shadow analysis engine accounts for surface albedo, seasonal variation, and bifacial gain — delivering accurate production estimates for any site condition.
Start Free TrialNo credit card required
Real-World Examples
Residential: White Roof Advantage (Florida)
A 10 kW bifacial system installed on a white TPO membrane commercial roof (albedo ~0.70) produces 14,200 kWh/year — 22% more than the same panels would produce on a dark shingle roof (albedo ~0.12). The additional 2,600 kWh/year at $0.13/kWh generates $338/year in extra savings, adding $6,760 in present value over 20 years. The bifacial premium of $800 pays for itself in 2.4 years.
Ground-Mount: Albedo Enhancement (Nevada)
A 2 MW bifacial ground-mount installation in Nevada replaces natural desert soil (albedo 0.15) with white crushed stone (albedo 0.40) beneath the array. The albedo enhancement costs $45,000 for materials and grading but increases annual production by 8.5%, adding approximately $52,000/year in energy revenue at the PPA rate. The investment pays back in under 11 months.
Seasonal Variation: Snow Belt (Minnesota)
A 50 kW commercial system in Minnesota uses monthly albedo inputs in its production model: 0.20 for May–October (grass), 0.50 for November and April (partial snow), and 0.75 for December–March (snow cover). The seasonal model predicts 72,400 kWh/year — 6% higher than the 68,200 kWh predicted using a flat 0.20 annual albedo. The improved accuracy helps the installer set more realistic savings expectations.
Sources & References
- NREL — Best Practices for Bifacial PV Modeling
- PVEducation — Albedo and Solar Radiation
- DOE — Bifacial Solar Technology
Frequently Asked Questions
What is a good albedo value for solar design?
There’s no single “good” value — it depends on the actual surface material at the project site. Use 0.20 for green grass, 0.10 for dark asphalt, 0.35 for concrete, and 0.70 for white roofing membranes. For bifacial systems where albedo significantly impacts production, measure or estimate the actual site albedo rather than using the default.
How does albedo affect bifacial solar panels?
Bifacial panels generate electricity from both their front and rear sides. The rear side captures ground-reflected light, which is directly proportional to the ground’s albedo. Higher albedo means more reflected light reaches the rear cells. On a white surface (albedo 0.70), bifacial panels can produce 20–30% more energy than on dark asphalt (albedo 0.08). This makes albedo one of the most important design inputs for bifacial systems.
Does snow increase solar panel output through albedo?
Yes, when the panels themselves are clear of snow. Fresh snow has an albedo of 0.80–0.90, reflecting far more light than typical ground surfaces. Clear, cold winter days with snow on the ground can produce surprisingly high output due to the combined effect of high albedo, cool panel temperatures (which increase efficiency), and clear-sky irradiance. However, snow covering the panels obviously blocks production entirely.
Can you artificially increase albedo for solar farms?
Yes. Ground-mount solar farms can increase albedo by installing white crushed stone, reflective ground cover, or light-colored vegetation beneath bifacial arrays. This practice, called albedo enhancement, can increase annual energy production by 5–15% for bifacial systems. The cost of ground preparation is typically recovered within 1–2 years through increased energy revenue.
About the Contributors
Content Head · SurgePV
Rainer Neumann is Content Head at SurgePV and a solar PV engineer with 10+ years of experience designing commercial and utility-scale systems across Europe and MENA. He has delivered 500+ installations, tested 15+ solar design software platforms firsthand, and specialises in shading analysis, string sizing, and international electrical code compliance.
CEO & Co-Founder · SurgePV
Keyur Rakholiya is CEO & Co-Founder of SurgePV and Founder of Heaven Green Energy Limited, where he has delivered over 1 GW of solar projects across commercial, utility, and rooftop sectors in India. With 10+ years in the solar industry, he has managed 800+ project deliveries, evaluated 20+ solar design platforms firsthand, and led engineering teams of 50+ people.
