Definition C

CAD-to-PV Mapping

The process of importing architectural or structural CAD drawings into solar design software to use as the base layer for panel layout, obstruction mapping, and system design — enabling accurate PV placement on buildings designed in AutoCAD, Revit, or other CAD platforms.

Updated Mar 2026 5 min read
Nimesh Katariya

Written by

Nimesh Katariya

General Manager · Heaven Green Energy Limited

Rainer Neumann

Edited by

Rainer Neumann

Content Head · SurgePV

Key Takeaways

  • CAD-to-PV mapping lets designers import DWG, DXF, IFC, and PDF floor plans directly into solar design software, bypassing manual roof tracing from satellite imagery
  • Scale calibration is the single most important step after import — an incorrectly scaled drawing produces inaccurate panel counts, wrong string lengths, and undersized or oversized systems
  • Layer mapping separates roof boundaries, structural elements, HVAC equipment, and obstructions from the original CAD file so each can be handled independently in the PV design
  • Roof boundary extraction from CAD drawings delivers sub-centimeter accuracy, compared to 15-30 cm accuracy typical of satellite or drone imagery
  • Obstruction identification from architectural plans catches vents, skylights, mechanical equipment, and future roof penetrations that may not be visible in aerial photos
  • For new construction projects, CAD-to-PV mapping is the only viable design method because the roof does not yet exist for satellite or drone capture

What Is CAD-to-PV Mapping?

CAD-to-PV mapping is the workflow of taking architectural or structural drawings created in AutoCAD, Revit, SketchUp, or similar CAD platforms and importing them into solar design software as the base layer for photovoltaic system design. The imported drawing provides the roof geometry, structural grid, obstruction locations, and dimensional data that designers need to place panels, route conduit, and plan the electrical layout.

In traditional solar design, the process starts with satellite imagery or a drone survey. The designer traces the roof outline from an aerial photo, estimates dimensions, and manually marks obstructions. This works well enough for existing residential roofs where high-resolution imagery is available. But it falls apart for new construction, complex commercial buildings, and any project where architectural plans already exist with millimeter-level precision.

CAD-to-PV mapping skips the guesswork. Instead of tracing a blurry roofline from Google imagery, the designer imports the architect’s actual roof plan — with exact dimensions, structural member locations, drain positions, and mechanical equipment placements already drawn. The result is a solar design built on verified architectural data rather than visual estimates.

The gap between satellite-based design and CAD-based design is the gap between estimating and knowing. When an architect hands you a roof plan with every penetration dimensioned to the millimeter, you don’t need to guess where the vents are or how far the parapet extends. You import the drawing, calibrate the scale, and start placing panels on geometry you can trust. For commercial projects above 100 kW, this accuracy difference translates directly into fewer change orders and faster installations.

Types of CAD-to-PV Import Workflows

Standard

2D Plan Import (DWG/DXF)

The most common workflow. A 2D roof plan from AutoCAD is exported as DWG or DXF and imported into solar design software. The designer selects relevant layers (roof outline, obstructions, setback lines), calibrates the scale using a known dimension, and uses the plan as the base layer for panel placement. Works for residential and commercial projects where a flat roof plan is sufficient.

Advanced

3D Model Import (BIM/IFC)

Building Information Models from Revit or ArchiCAD are exported as IFC files and imported into PV design tools that support 3D geometry. The model carries roof pitch, parapet heights, structural loads, and mechanical equipment volumes — giving the solar designer a complete 3D context for panel layout and shading analysis without manual measurements.

Conversion

PDF-to-CAD Conversion

When only PDF architectural plans are available (common with older buildings), specialized software converts the PDF geometry into editable DWG/DXF vectors. The conversion preserves dimensions and layer structure, though some manual cleanup is typically required. Accuracy depends on the original PDF quality — vector PDFs convert cleanly, while scanned raster PDFs require tracing.

Survey-Based

Point Cloud to CAD

LiDAR or photogrammetry scans of existing buildings produce 3D point clouds, which are then processed into CAD drawings (roof outlines, ridge lines, edge geometry). This approach combines the accuracy of on-site measurement with the editability of CAD files. Useful for complex roof shapes where satellite imagery lacks the resolution to capture geometry accurately.

Input Format Comparison

Choosing the right import format depends on what the architect or building owner provides and what level of detail the solar design requires.

Input FormatData AvailableAccuracyBest ForLimitations
DWG/DXF (2D)Roof outline, dimensions, obstructions, setbacks, annotationsSub-centimeter (as drawn)Residential and small commercial permit setsNo height data, no 3D shading context
IFC/BIM (3D)Full building geometry, structural data, MEP equipment, material propertiesSub-centimeter with 3D contextLarge commercial, new construction, complex multi-story buildingsRequires BIM-compatible solar software, larger file sizes
PDF (Vector)Roof outline, basic dimensions, annotationsCentimeter-level after conversionOlder buildings with only PDF plans on fileRequires conversion step, possible layer loss
PDF (Raster/Scanned)Visual roof plan only5-15 cm after manual tracingLegacy buildings, historical plan archivesManual tracing needed, no automatic layer separation
Point Cloud (LAS/E57)3D surface geometry, edge detection, height data1-3 cm depending on scan densityExisting complex roofs, heritage buildings, industrial facilitiesRequires post-processing to extract usable CAD geometry
Satellite ImageryAerial photo only, no dimensional data15-50 cm depending on provider and locationQuick residential estimates, initial prospectingNo structural data, obstructions not always visible, weather-dependent quality

Design Accuracy Formula

Design Accuracy Relationship
Design Accuracy = f(CAD Drawing Precision, Scale Calibration, Layer Completeness)

Where:

  • CAD Drawing Precision = dimensional accuracy of the original architectural drawing (typically ±1 mm for professional CAD files vs. ±15-50 cm for satellite imagery)
  • Scale Calibration = verification that the imported drawing’s unit scale matches the real-world dimensions — usually set by selecting a known reference dimension (a wall length, roof edge, or structural bay width) and assigning the correct measurement
  • Layer Completeness = whether all relevant layers (roof boundary, structural grid, obstructions, MEP equipment, setback lines) are present and properly separated in the imported file

A fully dimensioned CAD drawing with correct scale calibration and complete layer mapping delivers panel placement accuracy within 1-2 cm — close to what you’d achieve with a tape measure on the actual roof. Satellite-based designs typically achieve 15-30 cm accuracy for roof dimensions, which is adequate for small residential systems but creates measurable error on commercial-scale arrays where a 20 cm discrepancy across a 50-meter roof edge means multiple missing panels.

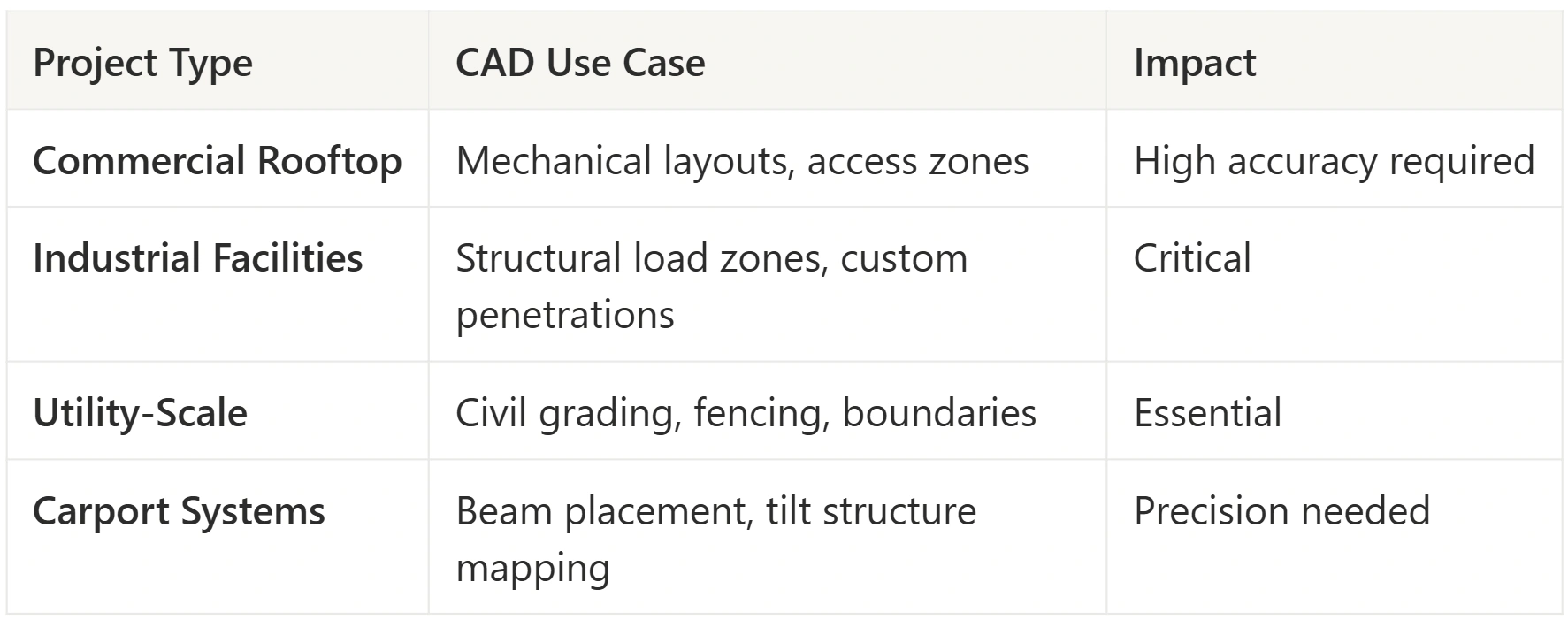

New Construction Projects

CAD-to-PV mapping is essential for solar-ready new construction. When a building is still in the design or construction phase, there is no roof to photograph with satellites or drones. The architect’s CAD drawings are the only source of roof geometry. Importing these plans into solar design software lets the solar designer coordinate panel layout with the architect before the roof is built — avoiding conflicts with HVAC equipment placement, drainage slopes, and structural load paths. In many jurisdictions, solar-ready design is now required by building code (2021 IEC and later), making CAD-to-PV mapping a standard part of the new construction workflow rather than an optional add-on.

The CAD-to-PV Mapping Process

The typical workflow follows five steps, regardless of the specific software used:

  1. File preparation — The architect or building owner provides the CAD file (DWG, DXF, or IFC). The solar designer opens the file and removes unnecessary layers (furniture, interior walls, landscaping, text annotations) to isolate roof-relevant geometry.

  2. Scale calibration — The designer selects a known dimension in the drawing (a wall length, structural bay width, or annotated roof edge) and confirms or corrects the scale. This step is critical. An uncalibrated drawing produces systematically wrong panel counts and string lengths.

  3. Layer mapping — Remaining CAD layers are mapped to solar design categories: roof boundary, ridge/hip/valley lines, obstructions (vents, skylights, HVAC units), setback zones, and structural grid. Some solar design software handles this mapping automatically; others require manual assignment.

  4. Geometry extraction — The software extracts the roof boundary as a polygon, identifies obstruction zones as keep-out areas, and creates the 2D or 3D surface model used for panel placement. For 3D imports (BIM/IFC), roof pitch and parapet heights are extracted directly from the model geometry.

  5. PV design overlay — With the CAD-derived roof model in place, the designer proceeds with standard PV layout: panel placement, string design, inverter selection, conduit routing, and shading analysis. The key difference from satellite-based design is that every dimension is based on architectural data rather than estimated from imagery.

Guidance by Role

  • Always verify scale calibration before placing panels. Select at least two known dimensions in the drawing and confirm they match. A single reference point can mask uniform scaling errors.
  • Strip unnecessary layers immediately after import. Interior partition walls, furniture blocks, and landscape elements add visual clutter and increase file size without contributing to the solar design.
  • Request the native CAD file rather than a PDF export whenever possible. Native DWG/DXF files preserve layer structure and dimensional precision. PDF conversions lose layer separation and may introduce rasterization artifacts.
  • Cross-reference the CAD drawing with satellite imagery for existing buildings. Overlay the imported plan on the aerial photo to catch discrepancies — additions, demolitions, or as-built deviations from the original architectural plans.
  • Use CAD-based designs for pre-construction planning to identify potential installation challenges (roof access, equipment staging areas, conduit routing) before the crew arrives on site.
  • Verify that the CAD file reflects current roof conditions for retrofit projects. Architectural plans may be years old — confirm that additions, HVAC replacements, and roof repairs are reflected in the drawing.
  • Leverage the dimensional accuracy of CAD-based designs to pre-cut conduit runs and rail lengths, reducing on-site fabrication time and material waste.
  • Request the final CAD-based permit set for field reference. Dimensioned CAD drawings are more useful during installation than satellite-traced layouts because they show exact measurements rather than visual approximations.
  • Ask for CAD plans early in the sales process for commercial prospects. Building owners and property managers typically have architectural drawings on file. Getting these plans upfront accelerates the proposal timeline.
  • Position CAD-based design as a quality differentiator when competing for commercial projects. Proposals built on architectural data carry more credibility with building owners and engineers than satellite-estimated layouts.
  • Use CAD-based accuracy to reduce change orders. Proposals that match the final installed system build customer trust. A system size that changes between proposal and installation signals poor planning.
  • Highlight the new construction opportunity. For developers and general contractors, solar design from CAD plans integrates directly into the construction timeline — no waiting for the building to be completed before starting the solar design.

When to Use CAD-to-PV Mapping vs. Satellite-Based Design

Not every project requires CAD imports. The decision depends on what information is available and how much accuracy the project demands.

Use CAD-to-PV mapping when:

  • The building is under construction or in the design phase (no roof to photograph)
  • Architectural plans are available and the roof geometry is complex (multiple levels, dormers, sawtooth roofs)
  • The project is commercial-scale (above 50 kW) where dimensional errors compound across large arrays
  • The AHJ or engineering reviewer requires dimensioned construction documents based on architectural data
  • The building has undergone recent renovations that aren’t reflected in available satellite imagery

Use satellite-based design when:

  • The building exists and high-resolution imagery is available
  • The roof is simple (rectangular, single-plane residential roofs)
  • Speed is the priority — residential proposals that need to go out in minutes, not hours
  • No CAD plans are available and the cost of obtaining them exceeds the project value

Most solar companies use both approaches. Residential teams work primarily from satellite imagery for speed. Commercial teams request CAD plans as standard practice. The AutoCAD solar layout glossary entry covers the traditional CAD-first design workflow in more detail.

Import CAD Drawings Directly into Your Solar Design

Upload DWG, DXF, and PDF plans to build accurate solar layouts on real architectural data.

Book a Demo

No commitment required · 20 minutes · Live project walkthrough

Sources and Further Reading

  • NREL — “Best Practices for Operation and Maintenance of Photovoltaic and Energy Storage Systems” (2018). Covers design documentation standards including the role of CAD-based plan sets in ensuring installation accuracy and long-term maintainability. NREL Technical Report
  • U.S. Department of Energy, SunShot Initiative — “Reducing Soft Costs of Solar Deployment” (2016). Documents how standardized design workflows, including CAD integration, reduce permitting time and design labor costs across the residential and commercial solar sectors. DOE SunShot
  • BuildingSMART International — IFC (Industry Foundation Classes) specification for BIM-to-solar interoperability. Defines the open data standard that enables 3D building models from Revit and ArchiCAD to be imported into PV design and energy simulation tools. IFC Standards
  • ASHRAE/ICC 240P — Standard for solar-ready building design, including requirements for architectural plans to include solar zone designations and structural load documentation that feeds directly into CAD-to-PV mapping workflows.

Frequently Asked Questions

Can you import AutoCAD files into solar design software?

Yes. Most professional solar design platforms accept DWG and DXF file imports. The process involves uploading the CAD file, selecting the relevant layers (roof outline, obstructions, structural elements), calibrating the scale to real-world dimensions, and using the imported geometry as the base layer for panel placement and system design. Some platforms also support IFC files from BIM tools like Revit. The imported drawing replaces satellite imagery as the design foundation, providing higher dimensional accuracy for panel layout and permit documentation.

What is CAD-to-PV mapping used for?

CAD-to-PV mapping is used to create solar panel layouts based on architectural drawings rather than satellite photos. The primary use cases are new construction projects (where no roof exists to photograph), complex commercial buildings (where satellite resolution is insufficient for accurate design), and any project where architectural plans provide better dimensional data than available imagery. The workflow produces more accurate panel counts, string layouts, and permit documents because every measurement comes from the architect’s verified drawings rather than estimated from aerial photos.

Is CAD-to-PV mapping more accurate than satellite imagery?

In nearly all cases, yes. Professional CAD drawings carry dimensional accuracy of ±1 mm, while satellite imagery typically provides ±15-50 cm accuracy depending on the provider, image resolution, and geographic location. For a residential roof, this difference may only affect one or two panels at the margins. For a 10,000 sq ft commercial roof, the difference can mean 5-15 panels — enough to change the system size, string configuration, and financial projections. CAD-to-PV mapping also captures obstructions (vents, drains, mechanical equipment) that may be invisible or ambiguous in aerial photos, reducing the risk of field changes during installation.
