Key Takeaways
- A solar installer app gives field crews instant access to design layouts, string diagrams, and permit documents without calling the office
- Photo documentation apps with GPS tagging and timestamps create automatic installation records for AHJ inspections and warranty claims
- Field service apps reduce truck rolls by 25–40% by catching missing information before crews leave the job site
- Offline capability is non-negotiable — 30–40% of residential job sites and most rural ground-mount locations have unreliable cellular service
- Digital checklists cut inspection failure rates by 50–65% compared to paper-based quality control processes
- Real-time status updates from a solar installation mobile app eliminate 8–12 daily phone calls between field teams and project managers
What Is a Field Installer App?
A field installer app is a mobile application that solar installation crews use on the job site to view system designs, follow installation checklists, document their work with photos, flag issues, and report project progress back to the office. The app runs on standard smartphones or tablets and replaces the printed plan sets, paper checklists, and phone calls that traditionally connect field teams to office staff.
The core problem is straightforward: installation crews arrive at a job site with a stack of printed drawings, a paper checklist, and a phone number to call when something does not match the plan. Plans get wet, pages go missing, and the office phone goes to voicemail. A solar installer app puts the current design files, interactive checklists, and a direct communication channel in the installer’s pocket.
NREL’s research on solar soft costs identifies field coordination inefficiencies as a significant contributor to the $0.28–0.40/W non-hardware costs in residential solar. A single return trip to address a missed installation detail costs $150–$350 in labor and vehicle expenses. Field service apps for solar companies address this directly by catching errors before the crew leaves the roof.
Types of Field Installer Apps
Design Access App
Provides field crews with view-only or interactive access to the solar system design created in solar design software. Installers can pinch-to-zoom on panel layouts, view string configurations, check inverter placement, and reference electrical line diagrams. Some apps overlay the design on satellite imagery so crews can orient themselves on the roof. Changes made by the design team sync automatically — no reprinting required.
Inspection / Checklist App
Guides installers through a step-by-step checklist tailored to the system type, AHJ requirements, and company quality standards. Each step can require a photo, a measurement, or a sign-off before the crew proceeds. Failed checks generate automatic alerts to the project manager. Digital checklists ensure nothing is skipped and create an auditable record for permit inspections and warranty documentation.
Photo Documentation App
Captures installation photos with automatic GPS coordinates, timestamps, and project tagging. Photos are organized by installation phase — pre-install roof condition, racking layout, wiring runs, grounding connections, and final array. Many AHJs now accept app-generated photo reports as part of the inspection package. Eliminates the problem of unorganized camera roll photos that no one can find six months later.
Communication / Workflow App
Handles real-time messaging between field crews and the office, issue escalation with photo attachments, material requests, and schedule updates. Project managers see live status dashboards showing which crews are on which jobs and what stage each installation has reached. Dispatchers reassign crews or schedule follow-up visits without a chain of phone calls. Integrates with CRM and project management systems to keep all stakeholders informed.

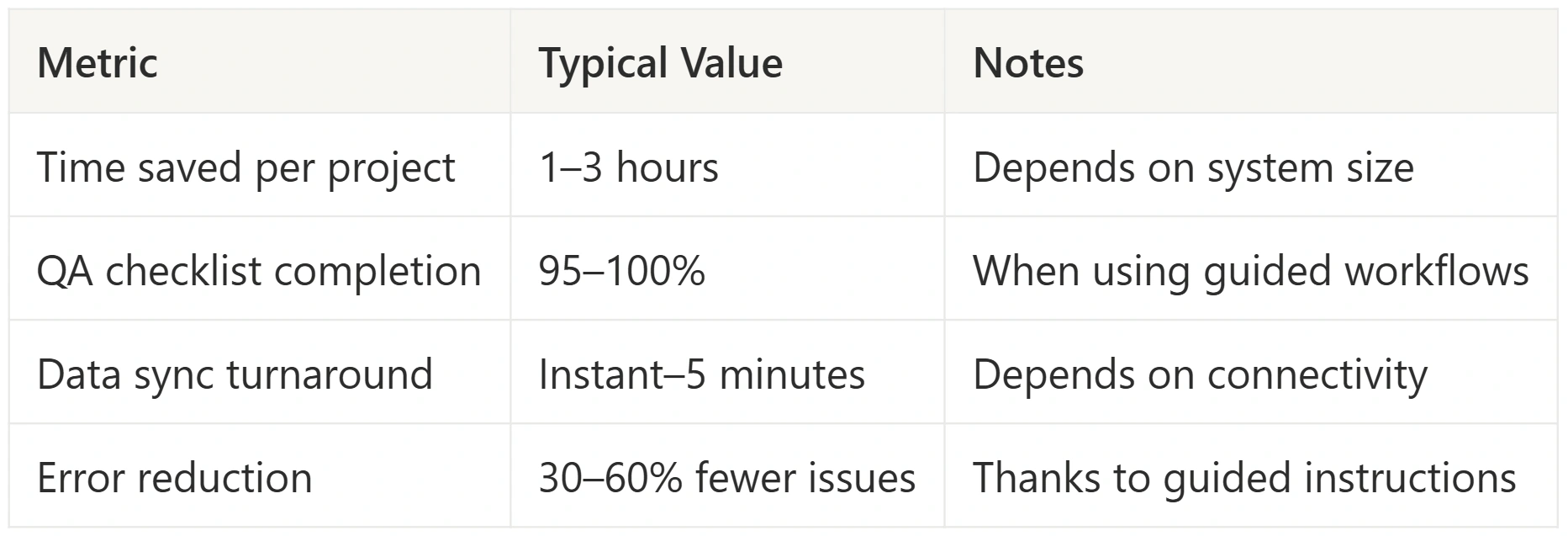

Feature Comparison
| Feature | Field Value | Time Savings | Error Reduction |
|---|---|---|---|
| Digital plan set access | View current designs on-site without printed plans | 15–30 min per job (no searching for pages, no outdated prints) | 70–80% fewer wrong-version errors |
| Interactive checklists | Step-by-step guided installation with mandatory photo gates | 20–40 min per job (no re-inspection for missed steps) | 50–65% fewer inspection failures |
| GPS-tagged photos | Automatic location, time, and project stamping on every image | 30–45 min per job (no manual photo sorting or labeling) | 90%+ photo traceability for warranty claims |
| Real-time status updates | Crew marks each phase complete as they finish | 45–60 min per day (eliminates status call interruptions) | Scheduling conflicts drop 60–75% |
| Issue reporting with photos | Field crew flags problems with annotated images | 1–2 hours per issue (vs. phone tag and return visits) | 40–55% faster issue resolution |
| Offline mode with auto-sync | Full functionality without cellular signal | Eliminates downtime at poor-signal sites | Zero data loss from connectivity gaps |
| Material verification scan | Barcode or QR scan confirms correct equipment on-site | 10–15 min per job (instant vs. manual cross-reference) | 85–90% fewer wrong-equipment installations |
Key Calculation
Truck Roll Reduction = (Avoided Return Trips / Total Projects) x Average Trip CostExample: A solar company completes 40 residential installations per month. Before adopting a field service app, 12 of those projects (30%) required at least one return trip to fix a missed checklist item, capture a forgotten photo, or verify a measurement. The average cost per return trip is $275 (labor, fuel, and lost scheduling capacity).
Without the app: 12 return trips x $275 = $3,300/month in avoidable truck rolls.
With a solar installer app: The checklist enforcement, mandatory photo gates, and real-time design access reduce return trips from 12 to 4 per month (10% of projects).
Monthly savings: (12 - 4) x $275 = $2,200. Annual savings: $26,400.
For companies running 100+ installs per month, the savings scale proportionally. A field service app paying for itself within the first month of deployment is common across the industry.
Many residential job sites sit in areas with weak or nonexistent cellular coverage. Rural ground-mount locations are worse. A solar installation mobile app that requires a constant internet connection will fail crews at the worst possible moment — on the roof, mid-install, when they need to check a string diagram or snap a required photo. Any field installer app worth adopting must cache all project data locally, allow full offline use (photos, checklists, notes), and sync automatically when connectivity returns. According to construction technology surveys, 30–40% of job site locations experience unreliable cellular service. Apps that handle this gracefully retain field crew adoption. Apps that do not get deleted within the first week.
Practical Guidance
- Download project data before leaving the shop. Even with offline support, syncing over the warehouse Wi-Fi is faster and more reliable than waiting for a cellular connection at the job site. Make it part of the morning routine: load the truck, sync the app, drive to the site.
- Take photos at every checklist step, not just the required ones. Extra documentation costs seconds but saves hours when a question comes up weeks later. Photograph the electrical panel label, the attic space, the conduit routing, and any pre-existing roof damage before you touch anything.
- Use the issue reporting feature immediately. If something on the roof does not match the design — a vent pipe where a panel should go, a different roof pitch than drawn — report it through the app with a photo and annotation right then. Calling the office and hoping someone writes it down is how details get lost.
- Verify materials against the BOM on arrival. Scan equipment barcodes or check serial numbers against the bill of materials before unloading. Discovering the wrong inverter model after it is wired in costs a full day to correct.
- Build AHJ-specific checklists. Each jurisdiction has different inspection requirements. Create checklist templates for your most common AHJs so crews follow the right steps for each location. This alone can cut inspection failures in half.
- Monitor the live dashboard, not the phone. If the app provides real-time crew status, use it. Knowing that Crew A finished racking at 11:30 AM and is starting electrical lets you schedule the inspector for 3 PM instead of guessing. The goal is fewer phone interruptions for both you and the crew.
- Review issue reports within 30 minutes. When a crew flags a design mismatch from the roof, they are waiting for direction. A fast response from the designer — pushed through the app — keeps the crew productive. A two-hour response means a crew sitting idle or moving on to the next job and requiring a return visit.
- Connect the app to your solar software design pipeline. The field installer app should pull designs directly from the same system where your designers create them. Manual file transfers between design software and field apps introduce version control errors — the exact problem you are trying to solve.
- Measure truck roll reduction as the primary ROI metric. Track the number of return trips per project before and after app adoption. This is the clearest financial signal and the easiest metric for field crews to influence. Target a 25–40% reduction within the first quarter.
- Mandate app adoption — do not make it optional. Partial adoption creates two parallel workflows (digital and paper) and doubles the coordination burden. Set a transition date, train the crews, and retire the paper checklists. Crews who resist typically come around within two weeks once they stop losing plan pages in the wind.
- Provide rugged devices or protective cases. Rooftop conditions destroy consumer phones. Invest in waterproof cases, screen protectors, and lanyards. A $50 case is cheaper than a $1,200 phone replacement and a day of lost data. Some companies issue dedicated job-site tablets with cellular plans.
- Use app data for crew performance and training. Photo documentation and checklist completion rates reveal which crews are thorough and which cut corners. Use this data constructively — for targeted training, not punishment. The goal is consistent installation quality across all crews.
Connect Field Crews to Design Data with Mobile Tools
SurgePV bridges the gap between office design and field installation — giving crews the drawings, documents, and data they need without a phone call.
Book a DemoNo commitment required · 20 minutes · Live project walkthrough
How Field Installer Apps Reduce Soft Costs
The U.S. DOE and NREL have identified soft costs — permitting, labor coordination, customer acquisition, and rework — as the largest remaining cost reduction opportunity in solar. Field installer apps target several of these categories directly:
Labor coordination: Real-time status updates and digital dispatch reduce the project management overhead per installation. A project manager who previously handled 8–10 installs per month can manage 12–15 when the status calls and manual scheduling disappear.
Rework and return trips: The DOE’s SunShot Initiative identified rework rates of 5–15% across residential solar installations. Field apps with mandatory checklists and photo gates push the rework rate toward the lower end of that range by catching errors before the crew leaves the site.
Inspection pass rates: AHJ inspections that fail on the first attempt cost $200–$500 in re-inspection fees and scheduling delays. Digital checklists built around specific AHJ requirements improve first-time pass rates from 75–80% to 90–95% in documented case studies.
Documentation for interconnection: Utilities and AHJs increasingly accept digital photo reports generated by field installer apps as part of the interconnection and permit close-out package. This eliminates the manual process of printing, organizing, and mailing physical photo documentation.
When combined with accurate designs from solar design software, field installer apps close the loop between what was designed in the office and what gets built on the roof — reducing the gap that causes most soft cost overruns.
Pair your field installer app with a standardized naming convention for photos. Use the format: [ProjectID]-[Phase]-[Item]-[Sequence] (e.g., 2026-0847-RACKING-FLASHING-01). When an inspector or warranty team needs to find a specific photo three years from now, consistent naming turns a 30-minute search into a 30-second filter. Most field apps support custom naming templates that auto-populate the project ID and phase.
- NREL — Solar Soft Cost Research — Analysis of non-hardware costs in solar installation, including labor coordination, rework, and field communication inefficiencies.
- U.S. DOE Solar Energy Technologies Office — SunShot Initiative research on reducing solar installation costs through technology adoption and process improvements.
- McKinsey — The Next Normal in Construction — Research on mobile technology adoption in field construction, including productivity gains from digital checklists and real-time communication tools.
Frequently Asked Questions
What features should a solar installer app include?
At minimum, a solar installation mobile app should provide offline-capable access to system designs and plan sets, digital checklists with photo requirements, GPS-tagged photo capture, real-time issue reporting with annotations, and status updates that sync to the office. Advanced features include barcode scanning for material verification, time tracking per installation phase, integration with CRM and project management platforms, and automatic generation of inspection-ready photo reports. The app should also support multiple concurrent projects so crews can switch between jobs without losing progress.
How does a field service app reduce truck rolls for solar companies?
Truck rolls happen when crews leave a job site without completing every required step — a missed photo, an unchecked measurement, or a design discrepancy that no one flagged. A field service app for solar prevents this through mandatory checklist completion (the crew cannot mark the job done until every item is checked), real-time design access (so discrepancies are caught on-site rather than discovered during office review), and instant issue escalation (the designer can respond within minutes instead of requiring a return visit). Companies that implement these apps typically see a 25–40% reduction in return trips within the first 90 days of use.
Can field installer apps work without internet on remote job sites?
The better ones can. A well-designed solar installation mobile app caches all project data — designs, checklists, material lists, and contact information — on the device before the crew heads to the site. Photos, checklist completions, notes, and issue reports are stored locally and sync automatically when the device reconnects to Wi-Fi or cellular. This is a critical feature for rural installations and ground-mount projects where signal strength is unpredictable. Before choosing a field installer app, test its offline functionality by putting your phone in airplane mode and verifying that every core workflow still functions.
About the Contributors
CEO & Co-Founder · SurgePV
Keyur Rakholiya is CEO & Co-Founder of SurgePV and Founder of Heaven Green Energy Limited, where he has delivered over 1 GW of solar projects across commercial, utility, and rooftop sectors in India. With 10+ years in the solar industry, he has managed 800+ project deliveries, evaluated 20+ solar design platforms firsthand, and led engineering teams of 50+ people.
Content Head · SurgePV
Rainer Neumann is Content Head at SurgePV and a solar PV engineer with 10+ years of experience designing commercial and utility-scale systems across Europe and MENA. He has delivered 500+ installations, tested 15+ solar design software platforms firsthand, and specialises in shading analysis, string sizing, and international electrical code compliance.
