Key Takeaways
- BIM (Building Information Modeling) creates data-rich 3D building models used across architecture, engineering, and construction
- IFC (Industry Foundation Classes) is the open data standard that enables BIM file exchange between different software platforms
- Solar PV design integrated into BIM workflows catches structural, electrical, and spatial conflicts before construction
- IFC export from solar design tools allows architects and engineers to include PV arrays in their master building model
- BIM-integrated solar design is increasingly required on large commercial and public-sector projects
- Reduces rework, change orders, and coordination failures between solar contractors and general contractors
What Is IFC/BIM Integration?
IFC/BIM integration refers to the practice of connecting solar PV design workflows with Building Information Modeling (BIM) environments through the Industry Foundation Classes (IFC) data exchange standard. BIM is a process — not just a file format — that creates intelligent 3D building models containing geometry, spatial relationships, material properties, and systems data for an entire building lifecycle.
IFC is the open, vendor-neutral file format (ISO 16739) that makes BIM interoperability possible. When a solar designer exports their PV layout as an IFC file, it can be imported into any BIM-capable platform (Revit, ArchiCAD, Tekla, Allplan) and merged with the architectural, structural, and MEP models. The solar array becomes a coordinated part of the building’s digital twin.
On commercial and public-sector projects, BIM coordination is no longer optional. Solar contractors who cannot deliver IFC-compatible design files are increasingly excluded from projects that require integrated BIM workflows. This is a competitive differentiator, not a technical nicety.
How IFC/BIM Integration Works for Solar
The integration workflow connects the solar design process with the broader building delivery pipeline.
Receive the BIM Model
The architect or general contractor shares the building’s BIM model (typically as an IFC or RVT file). This model contains roof geometry, structural framing, mechanical equipment locations, and penetrations.
Import into Solar Design Software
The solar designer imports the BIM model into their solar design software to use the accurate 3D roof geometry, including slopes, setbacks, obstructions, and structural attachment points.
Design the PV System
Panels, inverters, racking, and conduit runs are laid out on the BIM-accurate roof model. The designer works with real dimensions, real obstructions, and real structural data instead of assumptions.
Export as IFC
The completed solar design is exported as an IFC file containing 3D panel geometry, mounting hardware, electrical components, and associated metadata (module specs, wattage, string assignments).
Merge into Master BIM Model
The IFC export is imported into the project’s master BIM model. The BIM coordinator runs clash detection to identify conflicts between the solar array and other building systems (HVAC, roofing, structural).
Resolve Conflicts and Finalize
Any clashes (e.g., a conduit run intersecting ductwork, a panel overlapping a roof drain) are resolved collaboratively. The final coordinated model goes to construction.
Coordinated Model = Architectural Model + Structural Model + MEP Model + Solar PV Model (IFC)Types of BIM/Solar Integration
Different project types and software ecosystems call for different levels of integration.
IFC File Exchange
Solar design exported as IFC, imported into the BIM platform. One-directional transfer. Simple, widely supported, and sufficient for most projects. Works across any IFC-compatible software combination.
Direct Plugin (Revit, ArchiCAD)
Solar design tools that run as plugins within the BIM platform itself. Bi-directional data flow — changes in the building model automatically update the solar layout. Tighter integration but limited to specific BIM software.
Cloud-Based BIM Collaboration
Web-based platforms (Autodesk Construction Cloud, Trimble Connect) where multiple disciplines upload their models to a shared environment. Solar IFC files are uploaded alongside architectural and MEP models for real-time coordination.
CAD/DXF Export
2D or 3D CAD export (DXF/DWG) for projects not using full BIM. Less data-rich than IFC but widely compatible. Suitable for residential projects and smaller commercial work.

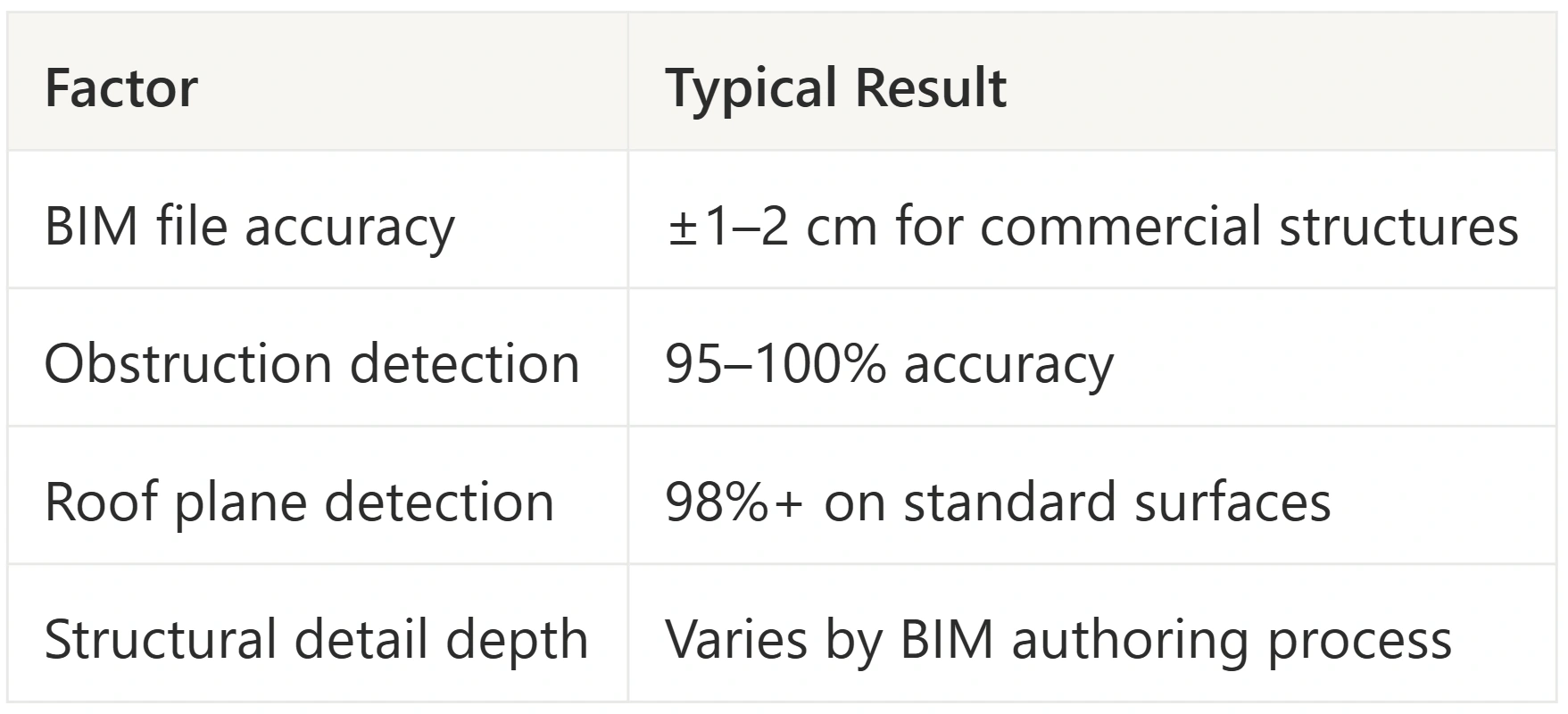

IFC export quality varies significantly between solar design tools. A good IFC export includes not just panel geometry but also metadata: module manufacturer, model number, wattage, string assignment, tilt angle, and azimuth. This metadata enables the BIM coordinator to generate accurate material schedules and specifications directly from the model.
Key Benefits of BIM Integration
| Benefit | Without BIM Integration | With BIM Integration |
|---|---|---|
| Roof Accuracy | Estimated from satellite imagery | Exact geometry from architectural model |
| Clash Detection | Discovered during installation | Caught during design phase |
| Change Orders | Frequent — 3–8 per commercial project | Reduced by 40–60% |
| Coordination Meetings | Manual markup on 2D drawings | 3D model walkthroughs |
| Material Scheduling | Separate BOM from solar designer | Auto-generated from BIM model |
| As-Built Documentation | Separate set of drawings | Integrated into building’s digital twin |
BIM ROI = (Avoided Change Orders + Reduced Rework) − BIM Integration CostPractical Guidance
IFC/BIM integration is becoming a standard requirement on commercial and institutional projects. Solar professionals using solar design software should prepare for this shift.
- Request the BIM model early. Ask for the architect’s IFC or RVT file during the design phase, not after. Designing on accurate geometry prevents costly revisions when the solar model is merged with the master BIM.
- Include metadata in IFC exports. Export panel specifications, string assignments, inverter locations, and conduit routing — not just geometry. Rich metadata makes your IFC file useful for coordination, scheduling, and commissioning.
- Use the structural model for attachment planning. The BIM structural model shows framing member locations, load capacities, and material types. Use this data to plan racking attachments accurately and avoid field modifications.
- Coordinate with MEP disciplines. HVAC equipment, rooftop units, plumbing vents, and electrical conduit all compete for roof space. BIM clash detection identifies these conflicts before construction.
- Use the BIM model on site. Load the 3D model on a tablet for field reference. Seeing exactly where each component goes — in 3D — reduces layout errors and speeds installation.
- Report as-built changes to BIM. If field conditions require deviating from the design, document changes and update the solar IFC file. The building owner needs an accurate as-built model for facility management.
- Participate in BIM coordination meetings. Attend the GC’s coordination meetings and present the solar model. This is where conflicts are resolved before they become costly field problems.
- Understand LOD requirements. Projects specify a Level of Development (LOD) for each discipline. LOD 300 requires modeled components with accurate geometry and dimensions. LOD 350 adds coordination interfaces.
- Position BIM capability as a differentiator. Many solar subcontractors cannot deliver IFC-compatible design files. Offering BIM integration puts your company in the running for larger commercial and institutional projects.
- Highlight risk reduction. BIM coordination catches design conflicts before they reach the field. For the building owner, this means fewer change orders, shorter timelines, and lower overall project risk.
- Address the “digital twin” value. The BIM model becomes a permanent asset for the building owner. They use it for facility management, maintenance planning, and future renovations — the solar array is part of that digital record.
- Respond to BIM mandates in RFPs. Government and institutional projects increasingly mandate BIM deliverables. If you cannot deliver IFC files, you cannot bid. Solar software with IFC export keeps you competitive.
Export Solar Designs to BIM Workflows
SurgePV’s solar designing platform supports IFC and CAD export, enabling your solar designs to integrate with any BIM environment.
Start Free TrialNo credit card required
Real-World Examples
Commercial: 400 kW Rooftop on a New Office Building
A general contractor building a 50,000 sq ft office complex requires all subcontractors to deliver IFC models at LOD 350. The solar subcontractor imports the architect’s BIM model, designs a 400 kW rooftop array using solar design software, and exports the layout as an IFC file. During BIM coordination, clash detection reveals that three planned panel locations overlap with rooftop HVAC units not visible in satellite imagery. The conflicts are resolved digitally, saving an estimated $18,000 in field rework.
Institutional: University Campus Solar Program
A university system mandates BIM deliverables for all capital projects. A 2 MW solar program across six buildings requires each building’s solar design to be integrated into the campus BIM model. The solar contractor delivers IFC files for each building, including panel geometry, inverter locations, and electrical routing. The university’s facilities team uses the integrated model for maintenance planning, ensuring solar equipment is included in roof inspection and replacement schedules.
Retrofit: BIPV on a Historic Building Renovation
An architect designing a renovation of a historic commercial building wants to integrate building-integrated photovoltaics (BIPV) into the facade. The solar designer works directly from the architect’s Revit model, placing PV modules as curtain wall elements. IFC export preserves the electrical properties of each BIPV panel, allowing the MEP engineer to incorporate the generation capacity into the building’s electrical design. The coordinated approach avoids the electrical conflicts that plague BIPV retrofits done without BIM coordination.
IFC Data in Solar Design
| IFC Element | Solar Application | Data Included |
|---|---|---|
| IfcSolarDevice | PV module representation | Module type, wattage, dimensions, tilt, azimuth |
| IfcDistributionElement | Inverter, combiner box | Equipment model, rating, location |
| IfcCableSegment | DC/AC wiring, conduit | Gauge, length, routing path |
| IfcBuildingElementProxy | Racking, mounting hardware | Attachment type, spacing, material |
| Property Sets | Custom metadata | String assignment, MPPT channel, certification data |
When exporting IFC from your solar design tool, validate the file using an IFC viewer (like BIM Vision or Solibri) before sending it to the BIM coordinator. A corrupted or incomplete IFC file wastes everyone’s time and undermines confidence in your team’s technical capability.
Frequently Asked Questions
What is IFC in the context of solar design?
IFC (Industry Foundation Classes) is an open file format for exchanging building data between different software platforms. For solar design, IFC export allows your PV layout — including panel positions, inverter locations, wiring routes, and equipment specifications — to be imported into BIM software like Revit or ArchiCAD. This lets the solar design be coordinated with architectural, structural, and mechanical systems in a single 3D model.
Why is BIM integration important for solar projects?
BIM integration catches design conflicts before construction begins. Solar arrays share roof space with HVAC equipment, vents, drains, and structural elements that may not be visible in satellite imagery. By merging the solar model with the building model in 3D, conflicts are identified and resolved digitally. This reduces field rework, change orders, and installation delays — saving time and money on commercial projects.
Do residential solar projects need BIM integration?
For standard residential solar installations, full BIM integration is typically not required. Satellite imagery and site surveys provide sufficient accuracy for residential rooftops. However, for new construction homes where an architect is already working in BIM, integrating the solar design adds value at minimal cost. For residential retrofits, a simple CAD/DXF export from the solar design tool is usually sufficient for permitting and installation documentation.
What software supports IFC export for solar design?
Several solar design platforms support IFC or BIM-compatible export, including SurgePV, PVcase, and Autodesk-based solutions. The level of IFC data richness varies between tools — some export only basic geometry, while others include full equipment metadata. When evaluating solar design software for BIM projects, test the IFC export quality by importing it into your BIM platform and checking that geometry, metadata, and property sets transfer correctly.
About the Contributors
General Manager · Heaven Green Energy Limited
Nimesh Katariya is General Manager at Heaven Designs Pvt Ltd, a solar design firm based in Surat, India. With 8+ years of experience and 400+ solar projects delivered across residential, commercial, and utility-scale sectors, he specialises in permit design, sales proposal strategy, and project management.
Content Head · SurgePV
Rainer Neumann is Content Head at SurgePV and a solar PV engineer with 10+ years of experience designing commercial and utility-scale systems across Europe and MENA. He has delivered 500+ installations, tested 15+ solar design software platforms firsthand, and specialises in shading analysis, string sizing, and international electrical code compliance.
