Definition B

Busbar

Thin metallic strips (typically silver or copper) printed on the surface of solar cells that collect and conduct electrical current from the cell fingers to the interconnect ribbons — with modern panels using 5-16+ busbars or multi-busbar (MBB) designs to reduce resistive losses.

Updated Mar 2026 5 min read
Keyur Rakholiya

Written by

Keyur Rakholiya

CEO & Co-Founder · SurgePV

Rainer Neumann

Edited by

Rainer Neumann

Content Head · SurgePV

Key Takeaways

  • Busbars are thin metallic conductors printed on a solar cell’s surface that collect current from the finer cell fingers and carry it to the interconnect ribbons connecting cells in series
  • The industry has evolved from 3-busbar (3BB) designs through 5BB and 9BB to multi-busbar (MBB) configurations with 12-16+ round wires, steadily improving efficiency and reliability
  • More busbars reduce resistive losses by shortening the distance current must travel through the thin cell fingers before reaching a collection point
  • Multi-busbar designs use up to 80% less silver per cell compared to traditional 3BB layouts, lowering material costs as silver prices rise
  • Each jump in busbar count adds approximately 0.1-0.3% absolute cell efficiency by reducing I²R losses and finger resistance contributions
  • MBB panels offer better shade tolerance, improved crack resilience (current can reroute around micro-cracks), and more uniform current collection across the cell surface

What Is a Busbar?

A busbar in solar cells is a flat or round metallic conductor — usually made of silver paste or copper wire — printed or placed on the front and rear surfaces of a photovoltaic cell. Busbars serve as the main collection highways: the thinner cell fingers gather current generated across the cell surface, and busbars aggregate that current and transfer it to the tabbing ribbons that connect one cell to the next.

The number of busbars on a cell directly affects how far current must travel through the high-resistance fingers before it reaches a low-resistance collection point. Fewer busbars mean longer finger paths, higher resistive losses, and more wasted energy as heat. More busbars shorten those paths and recover energy that would otherwise be lost.

A busbar is to a solar cell what a trunk line is to a road network. The cell fingers are local streets carrying small amounts of current, and the busbars are highways that collect and move that current efficiently to the panel’s electrical terminals. Adding more highways reduces congestion — and in a solar cell, congestion means resistive power loss.

Types of Busbar Designs

Legacy

Traditional Busbars (3-5BB)

Flat silver-paste strips screen-printed directly onto the cell surface. 3BB designs were standard until around 2016, then 5BB became the baseline. Wide strips (1.0-1.5 mm) that are visible as distinct lines on the cell. Higher silver consumption per cell — roughly 100-130 mg for 3BB and 80-100 mg for 5BB on a standard 166 mm cell.

Current Standard

Multi-Busbar (9-16BB)

Uses 9 to 16 thin round wires (0.2-0.3 mm diameter) instead of wide flat strips. Lower silver usage (30-50 mg per cell). Better light capture because round wires reflect incoming photons back into the cell surface rather than blocking them. The current industry standard for PERC, TOPCon, and HJT cell architectures.

Advanced

Wire Busbars (SMBB / Round Wire)

Super multi-busbar (SMBB) designs with 16-20+ ultra-thin wires bonded to the cell with conductive adhesive or low-temperature solder. Near-zero silver usage on the busbar itself — silver is only needed for the finger grid. Common in high-efficiency HJT modules where low-temperature processing is required to protect the amorphous silicon layers.

Emerging

Busbar-Less (Shingled Cells)

Eliminates busbars entirely by slicing cells into narrow strips and overlapping them like roof shingles. Current flows directly from one strip to the next through conductive adhesive along the overlap zone. No busbar shading losses, no tabbing ribbon, and maximum active cell area. Used in premium modules from manufacturers like SunPower and Maxeon.

Busbar Count Comparison

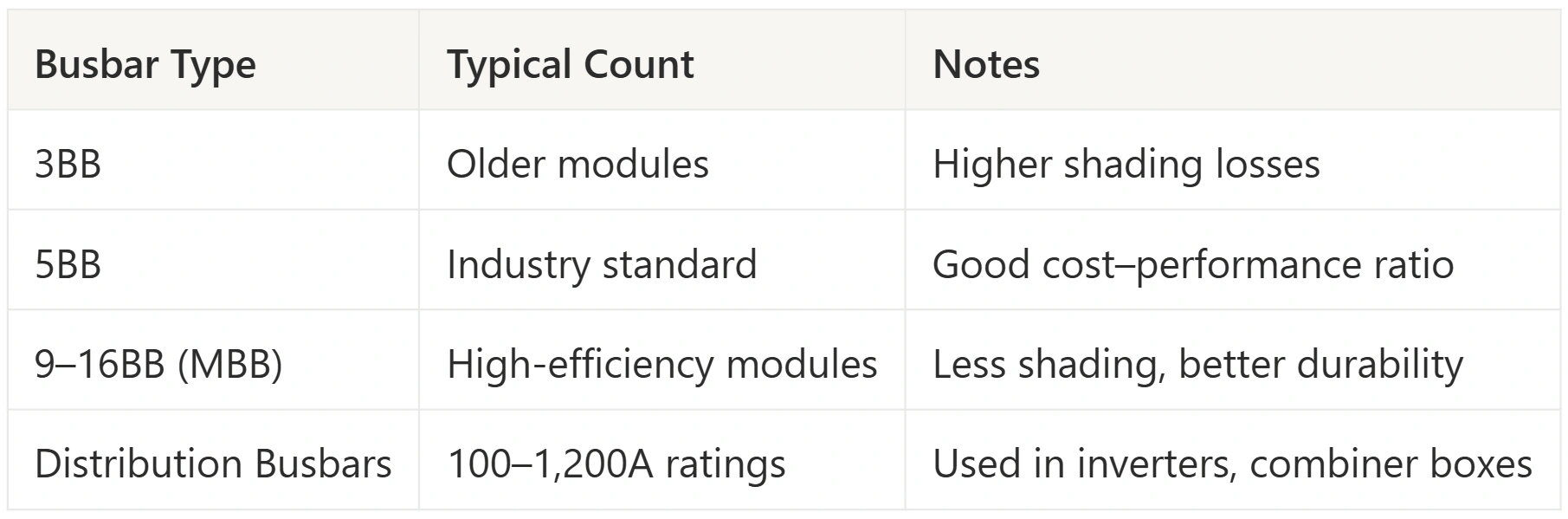

Busbar CountFinger Distance (mm)Silver Usage (mg/cell)Cell Efficiency ImpactCrack Tolerance
3BB~52 mm100-130BaselineLow — single crack can isolate large cell area
5BB~31 mm80-100+0.1-0.2% vs 3BBModerate — smaller isolated zones
9BB~17 mm50-70+0.2-0.4% vs 3BBGood — current reroutes around cracks
12BB (MBB)~13 mm30-50+0.3-0.5% vs 3BBVery good — high redundancy
16BB (MBB)~10 mm20-40+0.4-0.6% vs 3BBExcellent — minimal loss from micro-cracks
Busbar-lessN/A (shingled overlap)15-30+0.5-0.8% vs 3BBExcellent — strip isolation limits damage

Finger distance is the maximum distance current travels through a finger before reaching a busbar. Shorter distances mean lower I²R losses in the fingers, which is the primary efficiency gain from adding more busbars.

Resistive Loss Formula

Resistive Loss Reduction with Busbar Count
Finger Resistive Loss ∝ 1/n²

Where n is the number of busbars on the cell. This inverse-square relationship means that doubling the number of busbars reduces finger resistive losses by a factor of four. Going from 3BB to 9BB (tripling n) cuts finger resistive losses by roughly 9x.

In practice, the total cell-level efficiency gain is smaller than this formula suggests because finger resistance is only one component of total cell losses. Contact resistance, bulk recombination, and optical losses also play a role. Still, the 1/n² relationship explains why the jump from 3BB to 5BB delivered a noticeable gain, and why manufacturers continue pushing toward higher busbar counts.

Example: A standard 3BB cell with finger sheet resistance of 100 ohms/sq loses approximately 0.8% absolute efficiency to finger resistance. The same cell with 9BB reduces that loss to about 0.09%, recovering roughly 0.7% absolute efficiency — a meaningful gain when cell efficiencies are competing at the 23-25% level.

More Busbars = Better Shade and Crack Performance

Beyond efficiency, higher busbar counts improve a panel’s real-world resilience. When a micro-crack forms in a cell (from thermal cycling, hail, or handling), current can reroute through adjacent busbars instead of being completely blocked. In MBB panels with 12+ wires, a single crack typically causes less than 2% power loss to the affected cell, compared to 5-10% in a 3BB design. Similarly, partial shading affects a smaller fraction of the current path in MBB cells, resulting in less power loss before the bypass diode activates. When evaluating panels in solar design software, MBB modules will deliver more consistent long-term performance, especially in locations with high thermal cycling or hail risk.

Practical Guidance

  • Specify MBB panels for hail-prone regions. Multi-busbar cells maintain output after micro-crack formation because current has redundant collection paths. In areas rated ASTM Class 3 or higher for hail, MBB panels with 9+ busbars reduce the risk of gradual power degradation from cumulative micro-damage over the system’s lifetime.
  • Check busbar compatibility with cell-cutting technology. Half-cut cell panels already double the effective number of current paths. Combined with MBB, a half-cut 12BB module has 24 effective collection paths per cell half, reducing both resistive and mismatch losses. Confirm that your solar design software models the combined half-cut + MBB performance correctly.
  • Factor busbar type into degradation modeling. MBB panels with round wire busbars show lower solder joint fatigue over thermal cycles compared to flat ribbon connections. This translates to lower annual degradation rates (0.4% vs 0.55% typical), which compounds over 25-30 years of operation.
  • Use EL imaging data when available. Electroluminescence images reveal micro-cracks invisible to the eye. In MBB cells, EL images show cracks as thin dark lines that affect only the area between adjacent busbars. In 3BB cells, the same crack can darken a large inactive zone. Request EL data from module manufacturers when comparing panel options.
  • Handle MBB panels with the same care as standard modules. Despite better crack tolerance, MBB panels still require proper handling. Do not flex panels during installation, store them on edge rather than stacked flat, and avoid stepping on cells during rooftop work. The crack tolerance advantage applies to micro-cracks from thermal cycling, not gross mechanical damage.
  • Verify soldering and ribbon connections at the junction box. MBB panels route multiple thin wires to the junction box instead of two or three wide ribbons. Ensure the junction box connections are secure and that no individual wires have come loose during shipping — a single disconnected wire in a 12BB panel reduces output by roughly 8%.
  • Use IV curve tracing to verify cell performance. After installation, run a flash test or IV curve trace to confirm that all busbars are conducting properly. An IV curve with an abnormal knee or reduced fill factor can indicate a disconnected or high-resistance busbar connection.
  • Do not mix busbar types in the same string. Panels with different busbar counts can have slightly different current-voltage characteristics. Mixing 5BB and 12BB panels in the same series string can cause mismatch losses. Keep each string uniform in panel model and busbar configuration.
  • Position MBB as a reliability upgrade, not just efficiency. The efficiency gain from MBB is real but modest (0.3-0.6% absolute). The bigger selling point is long-term reliability: better crack tolerance, lower degradation, and more consistent output over 25-30 years. Frame it as the panel that keeps producing even after hail, thermal stress, and age take their toll.
  • Use busbar count as a quality signal. Panels with 9+ busbars are manufactured on newer, more advanced production lines. It is a reasonable proxy for overall manufacturing quality. When comparing proposals, highlight that your specified panels use current-generation MBB technology rather than legacy 3BB or 5BB designs.
  • Explain the silver cost advantage. MBB panels use significantly less silver per cell. As silver prices have risen above $30/oz, the material savings from MBB contribute to keeping panel prices stable. This is a cost-management story that resonates with commercial and utility buyers who are sensitive to commodity price risk.
  • Show the visual difference in proposals. MBB panels with round wire busbars have a more uniform, darker appearance because the thin wires reflect less light than wide flat busbars. For residential customers who care about aesthetics, this is a meaningful advantage over older panel designs with visible silver lines across each cell.

Compare Panel Technologies in Your Solar Design

SurgePV lets you model systems with different panel technologies side by side — compare MBB vs. legacy busbar panels and see the impact on production, degradation, and project economics.

Book a Demo

No commitment required · 20 minutes · Live project walkthrough

Sources & References

Frequently Asked Questions

How many busbars is best for solar panels?

For panels manufactured after 2023, 9 to 16 busbars (multi-busbar or MBB) is the current best practice. MBB panels offer the optimal balance of efficiency, silver consumption, crack tolerance, and manufacturing cost. Panels with fewer than 9 busbars are considered legacy technology at this point. The gains from going beyond 16 busbars are incremental, which is why some manufacturers are moving toward busbar-less designs like shingled cells instead. When selecting panels in your solar design software, prioritize MBB modules — they deliver better long-term performance for the same or lower cost per watt.

What is multi-busbar technology?

Multi-busbar (MBB) technology replaces the traditional 3-5 wide, flat silver-paste busbars with 9 to 16 or more thin round wires (typically 0.2-0.3 mm copper or silver-coated copper). These round wires are soldered or bonded to the cell surface at many contact points. The round cross-section reflects incoming light back into the cell at oblique angles instead of blocking it, recovering about 1-2% of the light that flat busbars would shade. MBB also reduces silver consumption by 50-80% because the wire itself provides the conduction path, and only a thin contact pad of silver paste is needed at each bonding point. The result is a cell that costs less to produce, wastes less light, loses less energy to resistance, and survives micro-cracks better than traditional busbar designs.

Do busbars affect solar panel performance?

Yes, busbar design directly affects both initial efficiency and long-term performance. On the efficiency side, busbar count determines how far current travels through the resistive cell fingers — more busbars mean shorter paths and lower I²R losses. The difference between a 3BB and 12BB cell is typically 0.3-0.5% absolute efficiency. On the reliability side, busbars determine how the cell responds to micro-cracks and partial shading. MBB cells with 12+ wires maintain over 98% of their output after typical micro-crack formation, while 3BB cells can lose 5-10% from the same damage. Over a 25-year system life, this reliability advantage compounds into meaningfully higher cumulative energy production.
